Molzen Corbin is currently working on the design of the rehabilitation of the interceptor and the required flood hazard mitigation measures. The existing interceptor will be rehabilitated using trenchless construction methods to limit the impact of construction activities to the community. Select locations are being slightly relocated to offset the interceptor further away from the river. Initial field work is being conducted by Molzen Corbin and specialty consultants to assess the required rehabilitation of the interceptor, subsurface soil conditions, locate existing underground utilities, establish easements for construction and maintenance of the existing and relocated interceptor, and topographic survey of sites where new facilities are being constructed.

FIELD WORK SCHEDULE

  • Closed Circuit Television Sewer Inspections: May 7-18, 2018

  • Geotechnical Engineering Soil Bores: May 21-25, 2018

  • Subsurface Utility Engineering: May 21-25, 2018

  • Manhole Condition Survey: June 2018

  • Ordinary High Water Mark Delineation: June 25-29, 2018. Staking is being placed in the field and we request that people not disturb these items.

  • Site Topography Surveys: July 2018

  • Sewer Line and Manhole Field Investigations: July 10-11, 2018

  • Additional Field Topography and Easement Surveying is taking place in November and December 2018

  • The Restoration of Existing Sewer Lines and Manholes Project is out for bid. Contractors may be seen along the project corridor examining the field conditions.

  • Easement surveying is ongoing for January-April 2019

DETAILED WORK SCHEDULES

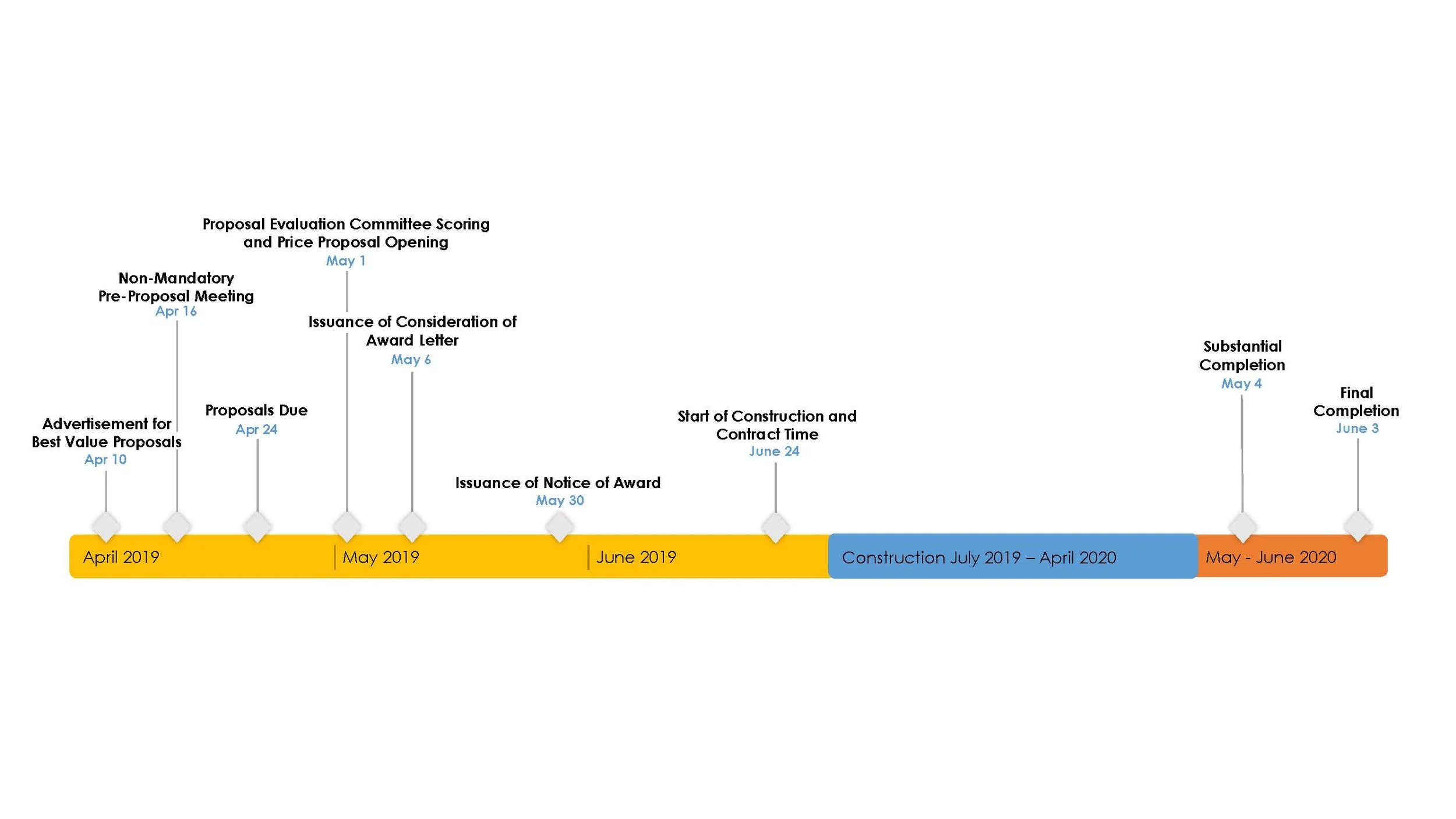

Restoration of Existing Sewer Lines and Manholes

Schedules_Restoration of Existing Sewer Lines and Manholes.jpg

Hazard Mitigation and Stabilization for Sewer Lines

Schedules_Hazard Mitigation and Stabilization for Sewer Lines.jpg

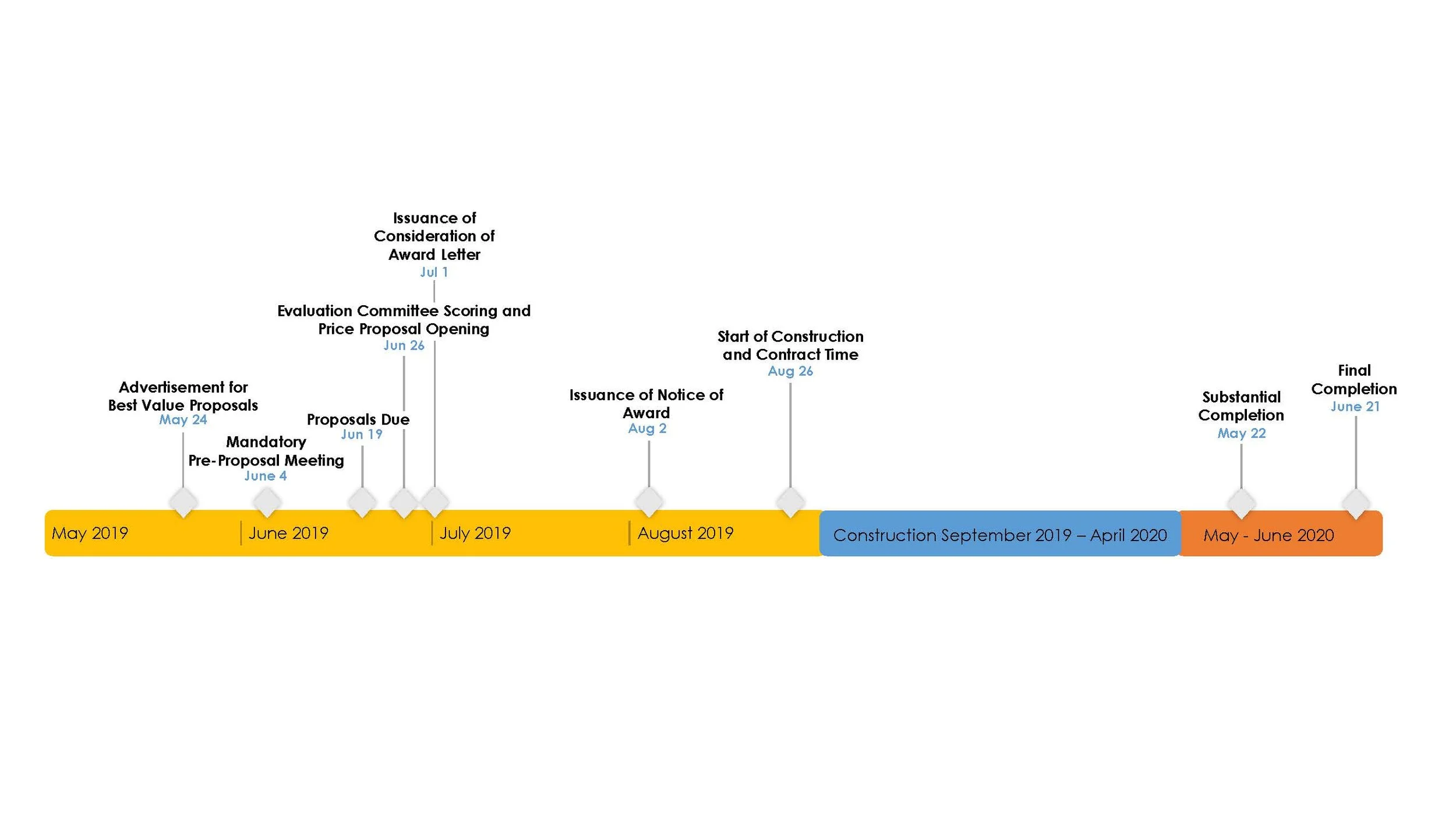

Lift Stations and Forcemains

Schedules_Lift Stations and Forcemains.jpg
